A construction crew in yellow work vests performing utility work around the base of an electrical pole.

Construction

Advance construction work

We will perform two types of prep work this year: Property demolition and the relocation of utility poles and equipment (also known as advance utility relocation).

This work will have some impacts on the community. CTA is committed to providing residents and local businesses with information about the work throughout this year and next year, including what to expect, when to expect it and what we will do to minimize those impacts.

Expected impacts

  • Noise – running air compressors, excavators, generators, general construction noise
  • Truck traffic
  • Street, alley closures
  • Sidewalk closures
  • Dust



Property demolition work

To build the Red Line Extension, we have acquired properties that are located in the future track alignment.

Demolition of properties is expected to begin late summer or fall 2024 and continue into 2025. Once work dates and plans are finalized, locations and timing will be shared with the public.

The area of this work includes select sites in the area between south of 95th Street to approximately
118th Street.

Advance utility relocation

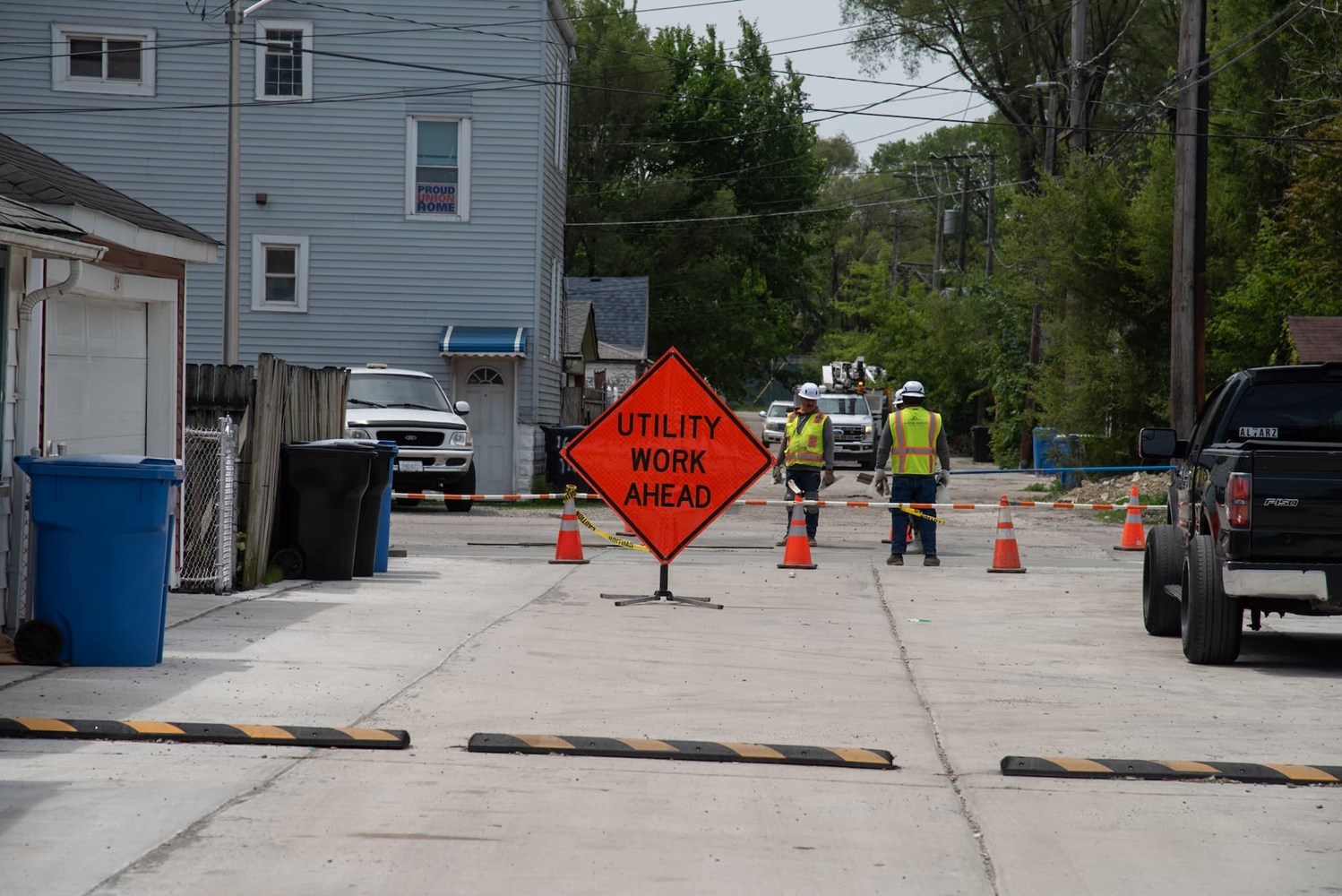

We will relocate utility equipment to clear the way for new track and station construction to avoid delays in the project when major construction is under way. This work is expected to begin this summer and occur throughout the Red Line Extension project area, including sections near the future track alignment in Far South Side communities. The work will include:

  • New underground trenches and relocating power and communication lines
  • Shorter poles will be installed to provide service to adjacent properties
  • Relocating power transformers on poles to underground

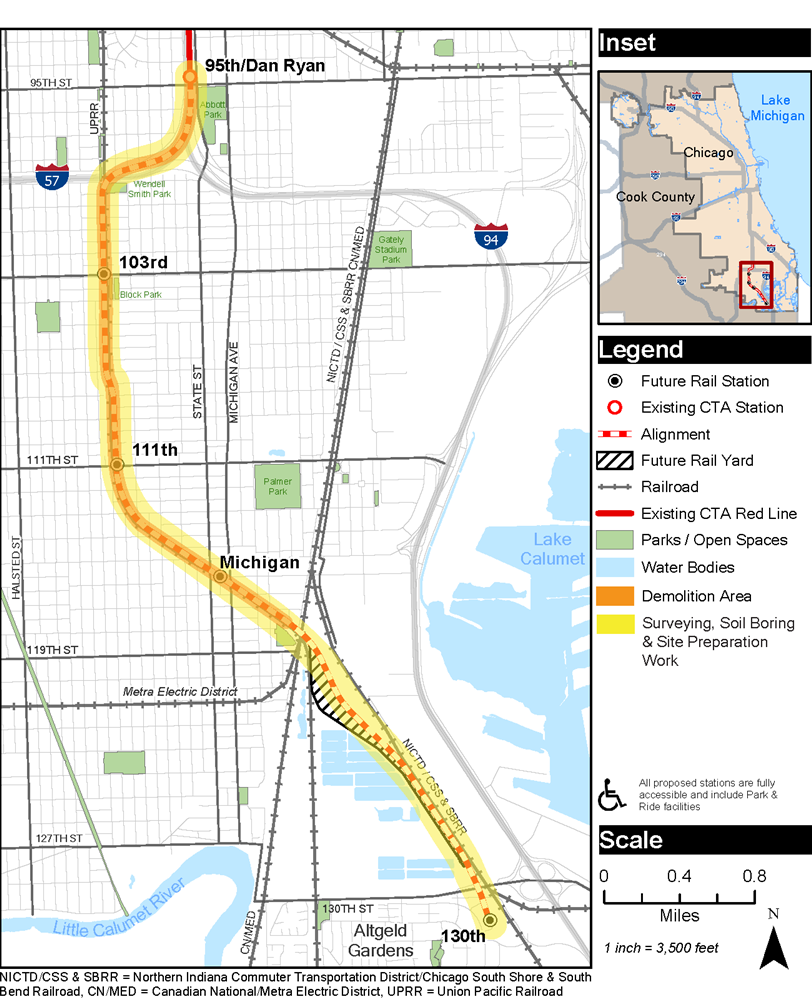

The area of this work is located from 95th Street to south of 130th Street.

Construction crews depicted performing utilities relocation work with heavy machinery and a backhoe.

Security

Safety and security for the community is a top priority, including proactively ensuring that properties that are awaiting demolition are secured and do not become nuisances for neighbors.

To do this, we work closely with a property management company, East Lake Management, that secures and regularly monitors and inspects all CTA-owned properties, addressing any issues that arise and swiftly responding to any questions or concerns raised by community members.

East Lake secures properties by conducting comprehensive site surveys, removing debris, boarding up windows, changing locks, mowing and weed removal graffiti removal, and snow removal. Any issues spotted or reported will be immediately addressed. Any criminal activity that is suspected or observed is immediately reported to Chicago Police.

While we make consistent efforts to be a good neighbor and steward of CTA properties, we strongly encourage neighbors to if they see something, say something by calling East Lake Management at (312) 842-5500. Any illegal or nuisance activity is unacceptable to CTA and we strongly recommend neighbors to call 911 if they believe they are in danger or witness what they believe to be criminal activity.

Construction activity notices (CANs)

As we work hard to build the Red Line Extension, we know that our construction can and does affect people who live and work nearby. This is why we provide advanced notice to communities in the RLE project footprint about work that we will be doing. These Construction Activity Notices (CANs) are also emailed to affected residents and businesses and physically posted in work site areas.

Receive these important updates delivered directly to your inbox by selecting your zone and future nearest station.

Sign up for RLE construction alerts!

Latest News

303 and 316 W 113th St site mobilization and preparation 12/16/2024

Preparation for property demolition work will include fence installation, utilities inspection, rodent abatement and partial sidewalk closures. Download Document

354 W. 109th St site mobilization and preparation 12/16/2024

Preparation for property demolition work will include fence installation, utilities inspection, rodent abatement and partial sidewalk closures. Download Document

409 W 103rd site mobilization and preparation 12/16/2024

Crews will perform site preparation work for upcoming property demolition. That work will include fence installation, utilities inspection and rodent abatement. Download Document

Chicago Fire Department training 328 W. 112th Place 12/09/2024

The Chicago Fire Department will perform training exercises at the unoccupied building located at 328 W. 112th Pl. Download Document

Chicago Fire Department training 348 W 109th Place 12/09/2024

The Chicago Fire Department will perform training exercises at the unoccupied building located at 348 W 109th Place. Download Document

Chicago Fire Department training exercise 354 E 118th St 12/09/2024

The Chicago Fire Department will perform training exercises at the unoccupied building located at 354 E. 118th St. Download Document

Chicago Fire Department training exercise 11/11/2024

An unoccupied property at 354 W 109th St will be used by Chicago Fire personnel for firefighter training exercises. Download Document

Chicago Fire Department training exercise on 103rd 11/11/2024

Chicago Fire personnel will use the unoccupied property at 409 W. 103rd St. for firefighter training exercises. Download Document

Advance Construction Work to Begin on the Red Line Extension This Summer 06/04/2024

The Chicago Transit Authority (CTA) today announced the next significant step for the Red Line Extension (RLE) Project: The start of advance construction – relocation of utility equipment and property demolition – this summer to make way for the new 5.6-mile Red Line Extension from 95th Street Terminal to 130th Street with four new Red Line stations. CTA also announced it will hold public meetings June 18, 25 and 26 to discuss the work with local residents and businesses. Read More about Advance Construction Work to Begin on the Red Line Extension This Summer

Results: 1 - 9 of 9 Articles

Public meetings

The RLE Project and upcoming advance construction work were discussed at public meetings on June 18, 25, and 26 of 2024. The public meetings included a presentation by CTA followed by a discussion period, during which members of the public were given the opportunity to asked questions and provided input.

View the announcement: official flyer

American Sign Language was available during the in-person public meeting and Facebook live stream. Spanish interpretation was available via the in-person public meeting only. All locations were also ADA accessible.

Frequently asked questions about advance construction

View the Construction and demolition section of our FAQs page
